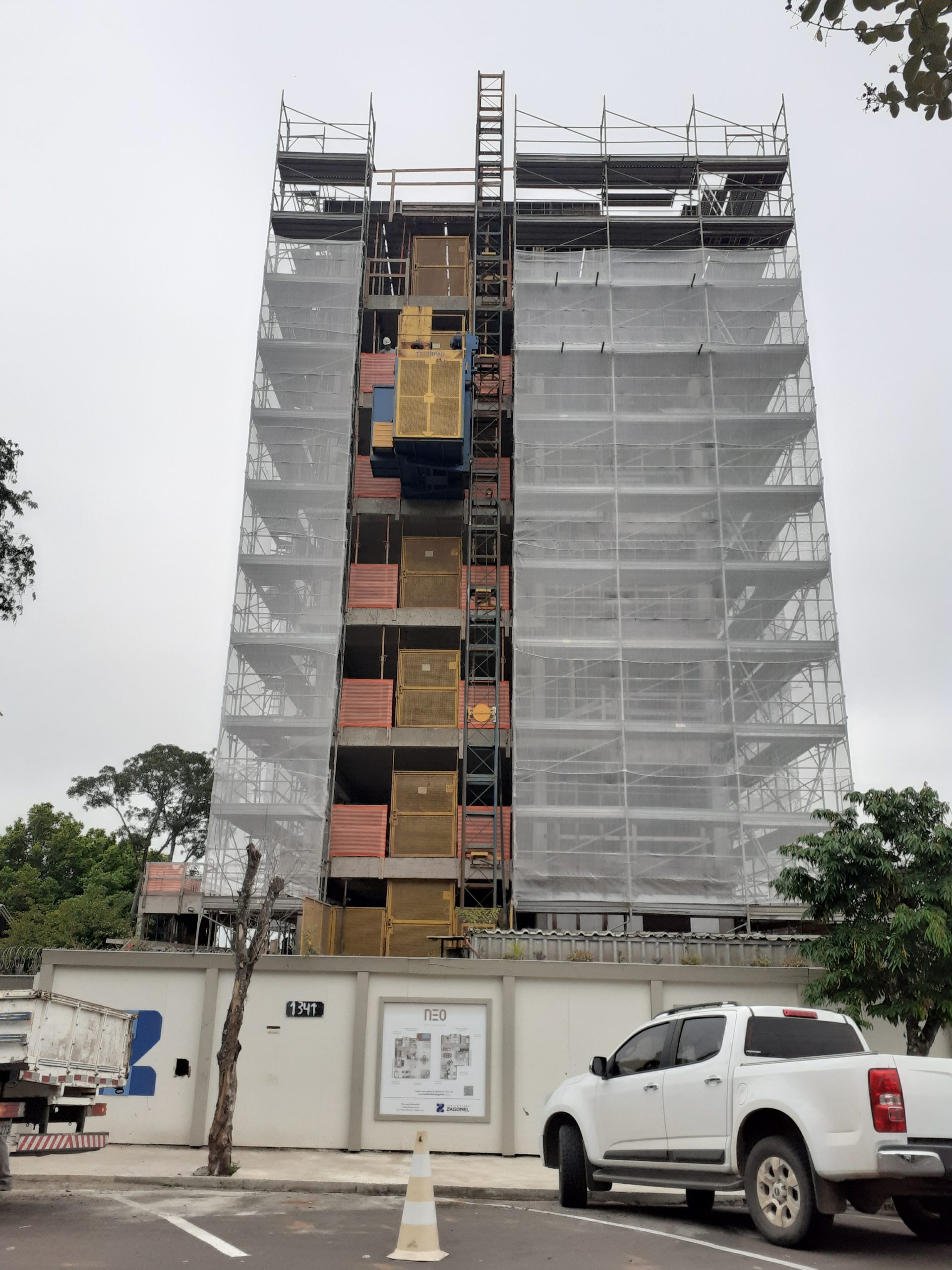

Neo Zagonel is a complete development in the heart of the city. A residential development on a plot of 1,100 m², consisting of 12 floors and 32 apartments (built area of
6,354 m²).
Start and expected end:
April 2019 to July 2023.
1. Impact of the Pandemic: The beginning of
The work coincided with the first months of the pandemic, leading to a temporary halt in construction and causing the need to recover the established schedule.
2. First Experience with the Topec ® SH System: The client had previous experience with solid slabs, but this project involved the construction of ribbed slabs, being the first time they used the Topec ® SH system in this context.
3. Efficient Equipment Management: The team ensured efficient equipment management, including monitoring loading and unloading to ensure the presence of SH products at the construction site.
1. Use of the Topec ® SH System: To recover the schedule, the Topec ® SH system was the solution
key to the execution of ribbed slabs, allowing greater agility in construction and enabling the execution of two and a half slabs per month.
2. Efficient Communication and Monitoring: Despite the location of the work, the presence and interaction
constant support from teams from both companies ensured efficient monitoring and fluid communication.
3. Transparent Management with SH Digital: The SH Digital platform played a fundamental role in providing transparent and agile management for all
aspects related to the equipment and resources used in the project.
Historically, the relationship between the company SH and Zagonel has been characterized by excellence in equipment management. None of the previous contracts had resulted in significant compensation, as Zagonel has always demonstrated exemplary care with the equipment supplied. In this particular project, this partnership stood out even more, as there was no compensation, reflecting the dedication and attention to detail on the part of the client.
Throughout the work, both the SH team and the Zagonel team maintained strict control over the flow of equipment, closely monitoring invoices, the balance on site, projects and progress reports. And this was all done efficiently through our SH platform
Digital. This tool played a fundamental role in providing transparent and agile management of all aspects related to the equipment and resources used in the project, further consolidating the partnership between the team
from SH and the Zagonel team. project.
The work created wooden shelves to separate the
Larger equipment and smaller equipment such as clamps were stored in bags. This separation by type and size of equipment made it easier when employees needed an item and it was easy to make a small inventory of equipment that was not being used.
used.
ZERO COMPENSATION:
Despite the location of the work being far from the Porto Alegre unit, the constant presence of teams from both companies ensured efficient monitoring and fluid communication. This project not only demonstrates the effectiveness of the Topec ® SH system in meeting customer needs, but also highlights the importance of strong collaboration and
careful management of resources to ensure the success of challenging ventures like this.
The zero compensation for the equipment in both contracts is certainly due to the strict control within the construction site, checking carried out at SH, reliable transport and correct use and storage of the equipment, with the full support of the SH assistance team on site. All the support from the technical side (projects and assistance), logistics and the fact that we returned everything we carried with zero compensation for missing parts.
